SJ Solarhub logo
SJ Solarhub

String vs Hybrid Inverter: 2026 Decision Guide for Commercial PV+Storage Projects

A side-by-side technical and financial comparison of string vs hybrid inverters for C&I solar deployments — with a decision tree, total-cost-of-ownership models, and field data from 200+ inverter installations.

Published: 2026-05-1713 min read
DL
Written by
Daniel Liang
Head of Engineering, SJ Solarhub · 12 yrs PV EPC
SH125CX hybrid PV+storage inverter — 125 kW commercial unit
Table of Contents
  1. TL;DR — quick answer
  2. What each inverter actually does
  3. Side-by-side technical comparison
  4. Decision tree
  5. Total cost of ownership scenarios
  6. When hybrid wins
  7. When string wins
  8. Two real field examples
  9. False economies & common pitfalls

Picking the wrong inverter architecture is one of the most expensive mistakes a commercial PV developer can make. We see it every quarter: a project owner installs string inverters to "save money," then realizes 18 months later that they need battery storage to manage demand charges or grid outages — and discovers that retrofit costs 30–45% more than choosing hybrid up-front would have. This guide is the framework we use internally to keep customers out of that trap.

1. TL;DR — quick answer

Choose hybrid inverter if any of these are true:

  • You plan to add battery storage within 5 years
  • Grid outages cost you more than USD 200 / hour in lost production
  • Your local utility charges demand fees (> 30% of total bill) or restricts solar export
  • Your site needs seamless backup transfer (≤ 20 ms)

Choose string inverter if all of these are true:

  • The project is grid-tied, export-only, and storage is not planned within 7+ years
  • Your utility pays full feed-in tariff or net metering
  • Capex is the binding constraint and you accept a future-retrofit penalty

If you're between the two, read on. The rest of this article walks through the technical, financial and lifecycle differences in detail.

2. What each inverter actually does

String inverter

A string inverter converts DC electricity from a series-connected group ("string") of PV modules into grid-compatible AC. That's its entire job. It cannot store energy, and it cannot operate during a grid outage (it's required to disconnect for line-worker safety — known as "anti-islanding").

Hybrid inverter

A hybrid inverter does everything a string inverter does, plus three additional functions:

  1. Direct battery interface (DC-coupled). Solar DC charges the battery DC directly, with one less conversion step than AC-coupled retrofits.
  2. Energy management. An onboard EMS decides when to self-consume, when to charge the battery, and when to export to grid — based on time-of-use tariffs and load forecast.
  3. Backup operation. A built-in transfer switch can island the protected loads in 20 ms or less when the grid fails, keeping critical equipment running on PV+battery.
String architecturePV arrayDCString inverterACGrid(To add battery later: install separate AC battery inverter — adds DC→AC→DC→AC losses)Hybrid architecturePV arrayDCHybrid inverterACGridDCBattery (DC-coupled)Backup loads
String: PV→inverter→grid only. Hybrid: PV→inverter, with native battery + backup load ports.

3. Side-by-side technical comparison

FeatureString inverterHybrid inverter
Battery integrationRequires separate AC battery inverterBuilt-in DC battery port
Backup during outageNo (anti-islanding)Yes, 20 ms transfer
Round-trip efficiency w/ battery85–90% (AC-coupled)92–96% (DC-coupled)
Capex (per kW)USD 80 – 130USD 180 – 280
FootprintCompact (wall-mounted)Larger (heat dissipation for EMS)
Peak efficiency98.4–98.8%98.0–98.6%
MPPT trackers2 – 122 – 6
CommunicationModbus RTU/TCP, Wi-FiModbus + dedicated EMS protocol + cloud
Typical warranty5–10 yr5–10 yr (EMS 5 yr)
Best use casesPure grid-tied solar exportSolar + storage + backup

4. Decision tree

Q1. Battery in plan?Within next 5 yearsYesNo→ Hybrid inverterDC-coupled, day-one storageQ2. Outage-sensitive?Critical loads on siteYesNo→ Hybrid + backup loads20 ms transfer, partial batteryQ3. Demand charges> 30% of bill?YesNo→ Hybrid + battery (TCO win)Peak shaving pays back in 4–7 yr→ String inverterLowest capex; export only
3-question decision tree. Hybrid wins 3 of 4 leaves; string wins only the pure-export, no-storage, low-demand-charge scenario.

Most decisions land in three to five clicks of this tree. If you reach the "split architecture" leaf (two different inverter types on the same project), you're in territory that needs a custom system-engineering review — talk to our team.

5. Total cost of ownership scenarios

Capex is only part of the story. Here are three real TCO scenarios we modeled for customers in 2025–2026. All figures normalized to USD per kW of PV array, over a 15-year horizon.

ScenarioString + no batteryString + AC battery (year 5 retrofit)Hybrid + battery (day 1)
Initial inverter capex$100$100$240
Initial battery system capex (kWh)$280
Year-5 retrofit capex (AC battery + storage)$430
15-yr energy losses to round-trip ineff.$95$45
Demand-charge savings (15 yr)$0$520$680
Backup revenue (avoided downtime, 15 yr)$0$0$240
Net 15-year TCO benefitBaseline−$105+$405

Modeled for a representative 500 kW Asia-Pacific industrial site with USD 0.12/kWh tariff, 25% demand-charge component, and 2 hours/year grid outage. Numbers vary materially with local tariffs — we run a custom model for every project quote.

6. When hybrid wins

  • Demand-charge tariffs. If demand charges exceed 30% of your bill, the battery + hybrid combo pays for itself in 4–7 years by shaving peak loads.
  • Time-of-use arbitrage. Where utility rates have a 3–5× spread between peak and off-peak, the EMS earns its keep by storing midday solar for evening peak consumption.
  • Critical-load backup. Server rooms, cold storage, manufacturing lines where one outage event costs more than the entire battery system.
  • Solar-export restrictions. Some grids cap export to 0–30% of installed capacity. The hybrid stores what you can't export.
  • Microgrid / island operation. Sites with weak or no grid connection — common in mining, agriculture, remote logistics hubs.

7. When string wins

  • Pure-export PV with full feed-in tariff. The inverter is just an AC converter; no need to pay for storage hardware you'll never use.
  • Pure-consumption PV with strong self-consumption already (> 90%). If the array's output is consumed in real-time, batteries add cost without revenue.
  • Tight capex budget on a known-life asset. If the building lease ends in 5 years, the longer hybrid TCO benefit may not be capturable.
  • Very high DC voltage / large arrays. Some hybrid inverters cap DC input voltage lower than string equivalents. For 1500 V utility arrays, central or string is often the right pick.

8. Two real field examples

Example 1: Huizhou 2.11 MWp rooftop — string inverters

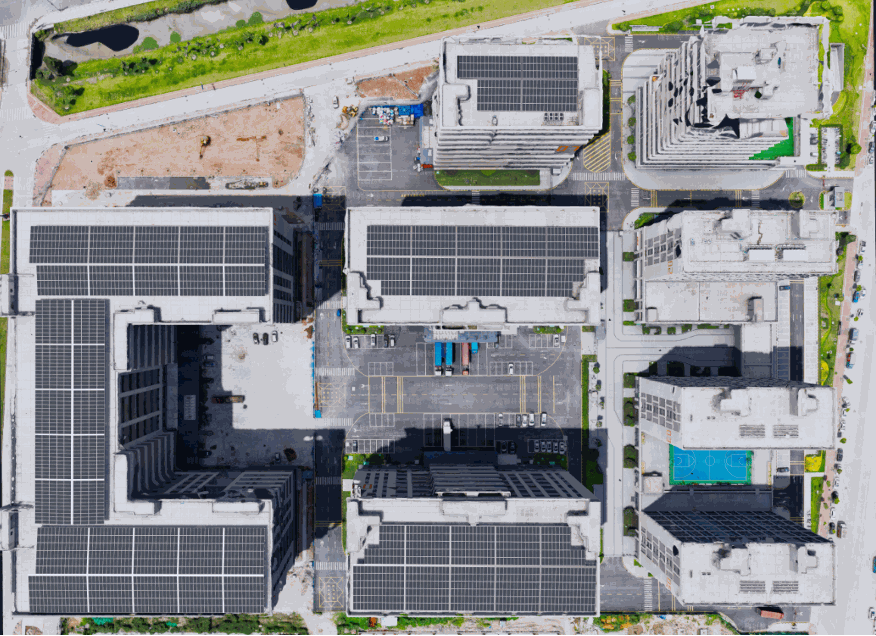

2.11 MWp rooftop PV plant in Huizhou using string inverters
20 × 110 kW string inverters distribute the 2.11 MWp generation across the factory roof.

This industrial customer had 100% daytime self-consumption (food processing operates 7am–7pm), full export rights at retail tariff, and no near-term battery plan. We specified 20 × Huawei SUN2000-110KTL-M2 string inverters with module-level optimizers on the sections subject to partial shading. Year-1 generation was 2.12 million kWh, payback 4.3 years. Full project file.

Example 2: Shenzhen 1.044 MWh BESS — hybrid + dedicated storage

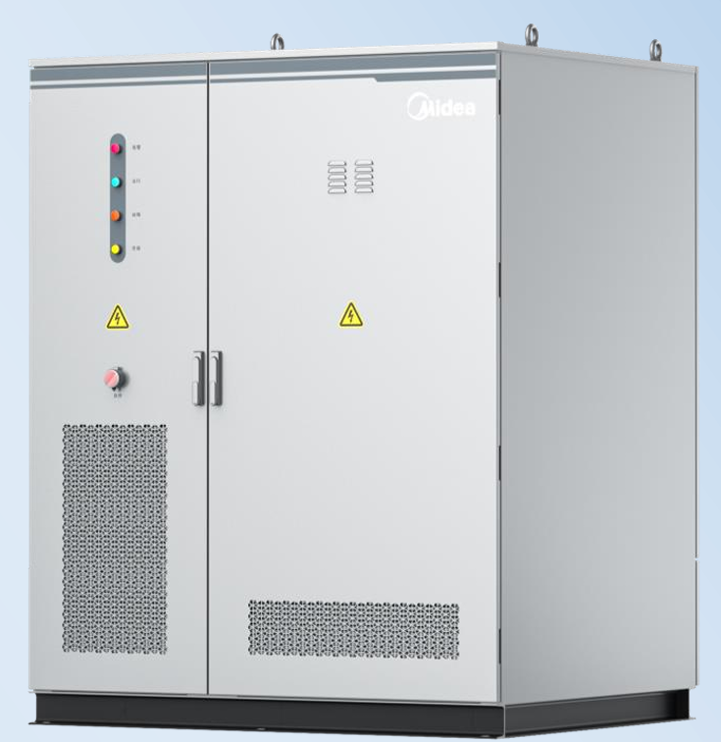

Shenzhen 1,044 kWh BESS deployment
Liquid-cooled BESS cabinet paired with PV+storage hybrid inverters for industrial peak shaving.

This customer faced a peak-demand tariff structure that made demand charges 38% of their electricity bill. We engineered a 1,044 kWh BESS with hybrid inverters that automatically peak-shave from 5–9 pm daily. The hybrid architecture was critical: AC-coupled storage would have lost ~5% of stored energy to extra conversion, lengthening payback by 7 months. Year-1 demand-charge savings: ~USD 92,000. ROI break-even modeled at year 5. Full project file.

9. False economies & common pitfalls

  1. "We'll add batteries later, so save money now." A future AC-coupled retrofit adds 30–45% to the eventual storage capex vs choosing hybrid day-one. If batteries are at all likely within 5 years, hybrid is cheaper end-to-end.
  2. Choosing hybrid for pure-export projects "just in case." The inverse mistake. You'll pay 1.8–2.5× for capacity you never use. If feed-in tariff is paying you fully and storage won't ROI, string is the correct call.
  3. Underspecifying inverter MPPTs. Each MPPT handles one independent string. Roofs with multiple orientations (east/west) or partial shading need more MPPTs. Some hybrid units only have 2; some string units offer 12. Match MPPTs to roof complexity.
  4. Forgetting battery chemistry compatibility. Not every hybrid inverter supports every battery brand. Check the manufacturer's certified battery list (we publish ours per product). LFP vs NMC matters for voltage range and BMS protocol.
  5. Skipping the load profile analysis. Hybrid TCO depends entirely on your tariff structure and load shape. Without a 12-month interval-meter analysis, the model is just a guess. Always insist on real data before final selection.

Further reading: EnergySage inverter comparison · IEA Renewables 2025 report. All TCO figures in this article reflect SJ Solarhub's customer-deployed projects and current 2026 pricing.

Frequently Asked Questions

Yes, but it requires a separate AC-coupled battery inverter — typically a stand-alone unit between your batteries and the AC bus. This works, but the round-trip efficiency is 4–6% lower than a DC-coupled hybrid because energy is converted DC→AC→DC→AC. If you're 80% sure you'll add batteries within 5 years, choose hybrid up-front and save the retrofit cost + efficiency loss.

Discuss your inverter selection with our application engineers

Send us your project specs (PV array kWp, storage requirement, grid profile, load profile) and our application engineering team will model both architectures and come back with an LCOE comparison — typically within 48 hours.

Request an inverter sizing review
